Systems Replacement Project
Stage 2 Processes: Procurement Plan
Version: 1.1
Last Updated: 11 September 2008
link to page 4 link to page 5 link to page 5 link to page 5 link to page 5 link to page 6 link to page 6 link to page 7 link to page 7 link to page 7 link to page 8 link to page 9 link to page 10 link to page 10 link to page 10 link to page 10 link to page 10 link to page 11 link to page 11 link to page 11 link to page 11 link to page 11 link to page 11 link to page 12 link to page 12 link to page 13 link to page 13 link to page 13 link to page 13 link to page 14 link to page 15 link to page 15 link to page 15 link to page 15 link to page 15 link to page 16 link to page 16 link to page 16
Systems Replacement Project
Stage 2
Table of Contents
1 Executive Summary ............................................................................................................................ 1
2 Introduction ......................................................................................................................................... 2
2.1 Project Background ..................................................................................................................... 2
2.2 Purpose ....................................................................................................................................... 2
2.3 Scope .......................................................................................................................................... 2
2.4 References .................................................................................................................................. 3
2.5 Terms and Definitions ................................................................................................................. 3
3 Procurement ........................................................................................................................................ 4
3.1 Regulatory Requirements............................................................................................................ 4
3.2 Approach ..................................................................................................................................... 4

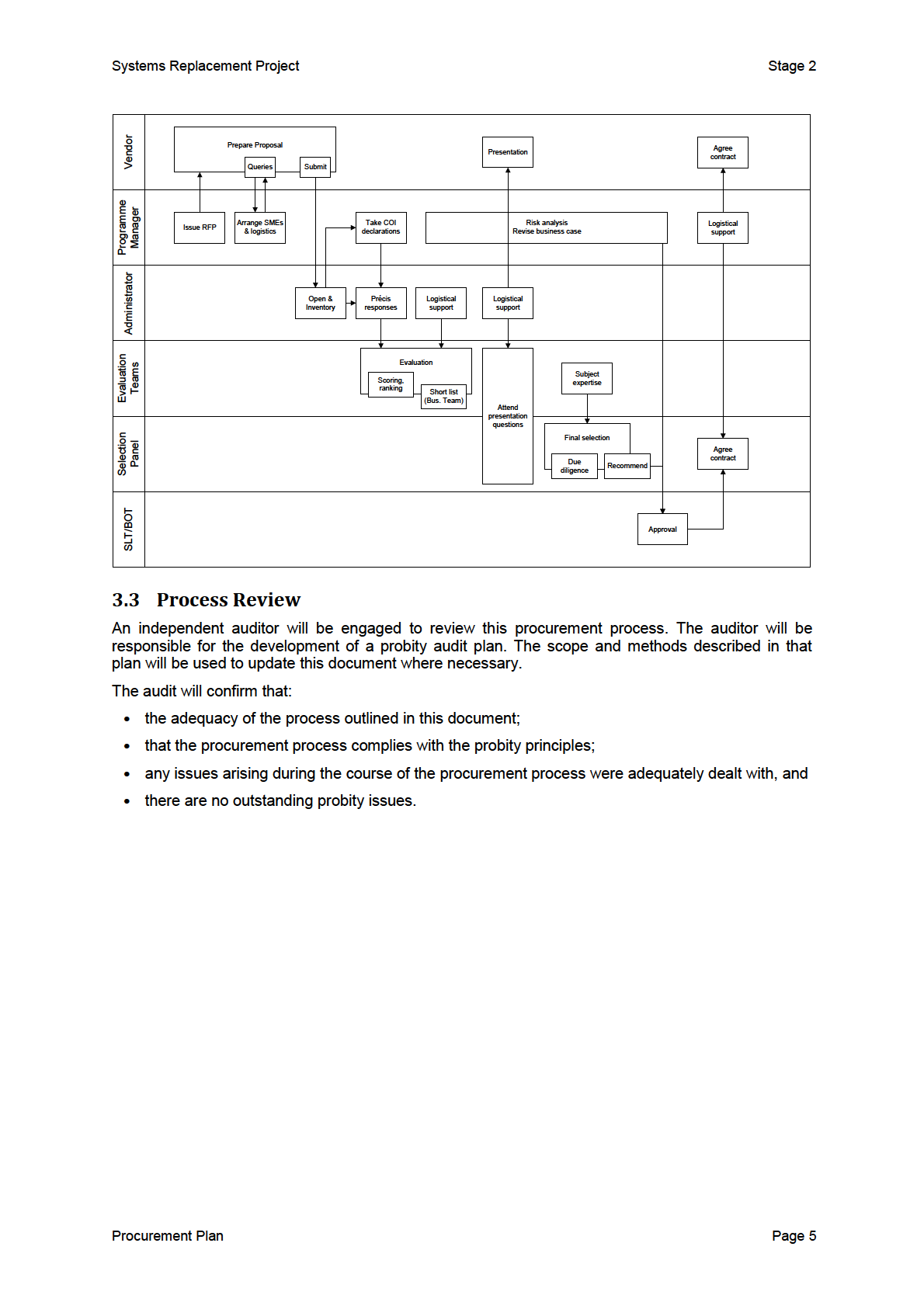

3.3 Process Review ........................................................................................................................... 5
3.4 Overview and Timetable.............................................................................................................. 6
4 RFP Procedures.................................................................................................................................. 7
4.1 RFP Issue .................................................................................................................................... 7
4.2 Communications – General ......................................................................................................... 7
4.2.1
Protocol .......................................................................................................................... 7
4.2.2
Single Point of Contact ................................................................................................... 7
4.2.3
Registration of Intent to Respond ................................................................................... 8
4.3 Requests for Additional Information ............................................................................................ 8
4.4 Receiving Responses .................................................................................................................. 8
4.4.1
On Time .......................................................................................................................... 8
4.4.2
Late Responses .............................................................................................................. 8
4.4.3
Individual Vendor Extensions ......................................................................................... 8
4.5 RFP Recall .................................................................................................................................. 9
4.6 Extending the Tendering Period .................................................................................................. 9
5 Evaluation Process ........................................................................................................................... 10
5.1 Précis......................................................................................................................................... 10
5.2 Evaluation Teams ...................................................................................................................... 10
5.2.1
General Responsibilities ............................................................................................... 10
5.2.2
Composition of Teams ................................................................................................. 11
5.2.3
Specialist Advice and Support ...................................................................................... 12
5.3 Team Conduct ........................................................................................................................... 12
5.3.1
Communication with Vendors ....................................................................................... 12
5.3.2
No Canvassing/Undisclosed Benefits .......................................................................... 12
5.3.3
Declarations of Interest ................................................................................................ 12
5.3.4
Confidentiality of Information ........................................................................................ 13
5.4 Briefing ...................................................................................................................................... 13
5.5 Methodology .............................................................................................................................. 13
Procurement Plan
Page i
link to page 16 link to page 16 link to page 17 link to page 17 link to page 18 link to page 18 link to page 18 link to page 18 link to page 18 link to page 18 link to page 19 link to page 19 link to page 19 link to page 19 link to page 19 link to page 20 link to page 20 link to page 21 link to page 21 link to page 21 link to page 22
Systems Replacement Project
Stage 2
5.5.1
Filtering ......................................................................................................................... 13
5.5.2
Scoring ......................................................................................................................... 13
5.5.3
Evaluation Report ......................................................................................................... 14
5.5.4
Short Listing (Down Select) .......................................................................................... 14
6 Selection Process ............................................................................................................................. 15
6.1 Selection Panel ......................................................................................................................... 15
6.2 Revision of Business Case........................................................................................................ 15
6.3 Presentations ............................................................................................................................ 15
6.4 Final Selection ........................................................................................................................... 15
6.5 Due Diligence ............................................................................................................................ 15
7 Agreement and Notification ............................................................................................................... 16
7.1 Two Step Process ..................................................................................................................... 16
7.2 Negotiation ................................................................................................................................ 16
7.2.1
Heads of Agreement..................................................................................................... 16
7.2.2
Essential Terms and Conditions ................................................................................... 16
7.3 Notification ................................................................................................................................. 17
7.4 Completion ................................................................................................................................ 17
8 Stage Closure ................................................................................................................................... 18
8.1 Tender Completion Report ........................................................................................................ 18
8.2 Update Project Documentation ................................................................................................. 18
Appendix A: Abbreviations & Common Terms....................................................................................... 19
Procurement Plan
Page ii
Systems Replacement Project
Stage 2
1 Executive Summary
The Systems Replacement Project (SRP) aims to replace several of The Correspondence School‟s
existing business applications, including Xtend and ākona, with new systems, and to provide
additional content management functionality for managing both learning materials and general
corporate documents.
The approach which will be adopted to securing new applications will be to identify commercial off-
the-shelf products from the market, rather than to develop bespoke software. These products will be
secured by means of a competitive tender process, as set out in this document.
Three tenders are included in the scope of this document, namely:
• Student Management System (SMS)
• Learning Management System and Learning Content Management System (LMS/LCMS), which
we have “branded” as our Online Teaching and Learning Environment (OTLE)1
• Electronic Document and Record Management System (EDRMS)
In broad detail, the tender process will proceed as follows:
• RFP documents, including detailed requirements and a model contract, have been widely
advertised, including on the NZ Government Electronic Tender Service website, which is widely
monitored by vendors.
• Various formal avenues for intending respondents to ask and have answers provided to their
questions have been defined.
• Proposals will be logged and stored securely, but not opened until the tender closes.
• All proposals will be opened together after the tender closes, and a précis prepared.
• The précis and copies to the proposals will be provided to evaluation teams, who will use a
common evaluation template to score responses individually. Then the evaluation teams will
each meet as a group to compile aggregate scores and rankings.
• One team, the Business Evaluation Team, which is common to all three tenders, will prepare a
short list of vendors with whom to proceed to presentations. All evaluation teams will document
their findings in brief Evaluation Reports.
• As soon as the short lists are known, work will commence on updating the business cases.
• Short listed vendors will present their proposals, provide generic2 demonstrations of their
offerings, and answer questions from TCS selection staff.
• A Selection Panel will choose the preferred vendor(s), and commence due diligence, a primary
component of which is careful reference checking.
• The Selection Panel will make final recommendations to the Board of Trustees for approval.
• The contract(s) will be completed in two steps, because completing all of the schedules to the full
contracts will require considerable investigative work (actually, the beginning of the
implementation project) and take a few weeks. However, the principles of the agreement can be
settled relatively quickly, and documented in a heads of agreement ahead of the full contracts.
• Unsuccessful vendors will be notified and thanked for their participation. At TCS‟s discretion,
debriefing meetings may also be provided.
The timetable for the process aims at completion of the contracts in November or December 2008.
1 We have done so to avoid being “typecast” as wanting a traditional LMS, because our requirements,
particularly in respect of cohort management, are atypical.
2 There will be insufficient time for vendors to perform any customisation of their products; what we
will see wil be their “out of the box” product.
Procurement Plan
Page 1
Systems Replacement Project
Stage 2
2 Introduction
2.1 Project Background
The Systems Replacement Project (SRP) aims to replace several of The Correspondence School‟s
existing business applications, including Xtend and ākona, with new systems, and to provide
additional content management functionality for managing both learning materials and general
corporate documents.
The approach which wil be adopted to securing new applications will be to identify “commercial” off-
the-shelf products from the market, rather than to develop bespoke software.
The programme will progress in three stages, with approval “gates” between them:
Stage 1: Preparation of the tender documents (complete)
Stage 2: Tendering, evaluation, product selection, contract negotiations (described herein)
Stage 3: Implementation
Three systems fall within the scope of this procurement plan, namely:
• Student Management System (SMS)
• Online Teaching and Learning Environment (OTLE), in turn comprising:
o Learning Management System (LMS)
o Learning Content Management System (LCMS)
o and possibly some additional collaboration components
• Electronic Document and Record Management System (EDRMS)
Selection of one or more vendors to provide replacement software will be conducted by open tender,
as described herein.
The Procurement Plan is dependent upon the inclusion of complete and clear descriptions of the new
system requirements within the Request for Proposal (RFP) documents prepared during project
Stage 1.
Abbreviations and common terms used in this Procurement Plan are defined in Appendix A.
2.2 Purpose
The purpose of this Procurement Plan is to define the process that TCS will employ to identify and
engage external vendors to supply and implement the new SRP applications.
2.3 Scope
Three tenders are included in the scope of this document, namely:
• Student Management System (SMS)
• Learning Management System and Learning Content Management System (LMS/LCMS), which
we have “branded” as our Online Teaching and Learning Environment (OTLE)
• Electronic Document and Record Management System (EDRMS)
In each case, the scope for the services to be supplied includes:
• Specification and design
• Analysis and definition of detailed functional requirements
• Application configuration/customisation design
• Establish host environment
• Implementation
• Integration
Procurement Plan
Page 2
Systems Replacement Project
Stage 2
• Data migration
• Testing
• System documentation
• Training
• Support services
2.4 References
The following are the reference documents for this Procurement Plan:
Reference
Description
TCS Procurement
TCS Governance Policies, Procurement Policy, BOT reference March 2007, Item 13)
Policy
Programme
The PID is a reference document against which the Systems Replacement Project
Initiation Document
activities and deliverables can be assessed.
(PID)
Mandatory Rules for
Standards and procedural requirements for the conduct of procurement by government
Procurement by
departments. Published 2 May 2006.
Departments
http://www.med.govt.nz/templates/MultipageDocumentTOC
19669.aspx
Government
This Ministry of Economic Development guide explains the Governments procurement
Procurement in
principles and is intended to help government departments and other taxpayer-funded
New Zealand –
agencies to support the Government's Procurement Policy.
Policy Guide for
http://www.med.govt.nz/templates/MultipageDocumentTOC
29467.aspx
Purchasers
Procurement: A
The Auditor-Generals publication that sets out the principles of good practice and gives
Statement of Good
detailed advice on planning and conducting the procurement process and contract
Practice
management.
http://www.oag.govt.nz/2008/procurement-guide/
Guidelines for
These State Service Commission and Treasury guidelines set out the expectations and
Managing and
standards for managing and monitoring major IT projects within the New Zealand
Monitoring Major IT
Government sector.
Projects
http://www.ssc.govt.nz/display/document.asp?DocID=6418
In addition, several general policy documents (including the Code of Conduct, Privacy Procedures for
staff including contractors, Media and Public Enquiries Policy, and the draft Conflict of Interest
Procedures for staff) were consulted, to ensure consistency with overall TCS policy.
2.5 Terms and Definitions
The definitions of terms and abbreviations used in this document can be found in Appendix A.
Procurement Plan
Page 3
Systems Replacement Project
Stage 2
3 Procurement
3.1 Regulatory Requirements
The New Zealand public sector is expected to conduct procurement activities based on the principles
of:
• best value for money over whole of life;
• open and effective competition; and
• fair opportunity for domestic vendors
(refer
Policy Guide for Purchasers, issued by the Ministry of Economic Development).
Although not required to do so by law, TCS voluntarily complies with the
Mandatory Rules for
Procurement by Departments, published by the Ministry of Economic Development (refer to TCS
Governance Policies → Procurement Policy, BOT reference March 2007, Item 13).
In summary, the
Mandatory Rules “reflect and reinforce New Zealand‟s established policy of
openness and transparency in [public sector] procurement.”
These principles have also been applied in the preparation of this Procurement Plan, along with the
best practice recommendations and rules provided in the other documents listed in the references
section.
3.2 Approach
The procurement process comprises the following steps:
• Publish open Requests for Proposal on the New Zealand Government Electronic Tenders
(GETS) web site.
• Initial scan to identify compliant/non-compliant responses
• Evaluation Team scoring and ranking
• Short-listing for presentations
• Final selection
• Rework Business Cases
• Sign-off
• Agree basic contract parameters; sign heads of agreement
• Commence analytical work, partly to inform contract schedules
• Sign full contract
A graphical view of the steps to this process is provided below.
Procurement Plan
Page 4
Systems Replacement Project
Stage 2
3.4 Overview and Timetable
An approximate timetable for the principal milestones is set out below. Milestones advised to vendors
in the RFP documents are indicated (“
In RFP?” column) together with quicker and slower time
forecasts which are not necessarily best case and worst case estimates (more like lower and upper
quartile).
A more detailed timetable is maintained in the project documentation.
Event
In RFP?
Quicker
Slower
Issue SMS+OTLE RFP
Y (11 Aug)
11-Aug-08
11-Aug-08
Issue EDRMS RFP
Y (18 Aug)
18-Aug-08
18-Aug-08
Q&A SMS+OTLE
Y (25 Aug)
25-Aug-08
25-Aug-08
Q&A EDRMS
1-Sep-08
1-Sep-08
Appoint administrator
1-Sep-08
8-Sep-08
Finalise functional evaluation matrices
8-Sep-08
8-Sep-08
Finalise functional evaluation teams
8-Sep-08
8-Sep-08
Brief functional evaluation teams
12-Sep-08
12-Sep-08
RFP Closes
Y (15 Sep)
15-Sep-08
15-Sep-08
Open and inventory responses
16-Sep-08
16-Sep-08
Take COI declarations
18-Sep-08
18-Sep-08
Précis responses, copying, etc.
22-Sep-08
29-Sep-08
October BOT meeting
1-Oct-08
1-Oct-08
Short-list
Y (6 Oct)
6-Oct-08
13-Oct-08
Revise business case
13-Oct-08
20-Oct-08
Presentation
Y
13-Oct-08
20-Oct-08
Final Selection
20-Oct-08
3-Nov-08
Reference Check
Y (27 Oct)
27-Oct-08
10-Nov-08
Revised BC approved
27-Oct-08
10-Nov-08
Commence Negotiation
Y (27 Oct)
27-Oct-08
10-Nov-08
Notification
Y (3 Nov)
3-Nov-08
17-Nov-08
Limited Commencement
3-Nov-08
17-Nov-08
November BOT meeting
5-Nov-08
5-Nov-08
Contract Completed
24-Nov-08
22-Dec-08
Procurement Plan
Page 6
Systems Replacement Project
Stage 2
4 RFP Procedures
The purpose of the RFP process is to solicit responses in the form of proposals from appropriate
vendors to supply and implement suitable applications, assist with training, and provide on-going
support services for the replacement systems. The requirements of the systems are detailed in the
Request for Proposal documents.
The RFP process must collect enough information to allow the selection of the preferred vendor and
for the planning and negotiation of an engagement contract. The RFP documents set out the
information required and include details of the following:
• the deliverables and specific duties that the successful vendor will be required to perform;
• the mechanisms for communications prior to contract awards, and terms and conditions that the
vendor must adhere to if awarded the contract;
• instructions that cover the vendor‟s proposal content as wel as requirements for physical
preparation and delivery of the proposal, and
• the criteria on which each proposal will be assessed.
The key principle in administrating the tendering process is to ensure that all potential vendors are
treated in a fair and equitable manner. The following sections detail the RFP process activities that
are to be performed to ensure that this principle is applied.
A high level explanation of the process, together with strict compliance rules, is outlined to
prospective RFP respondents in Part A of the tender documentation (especially Section 4.2).
4.1 RFP Issue
The RFP package will be posted on GETS (automatically picked up by the Australian Tenders.Net) to
ensure:
• widest possible advice to potential vendors in the New Zealand market
• effective point-in time publication ensures no vendor receives an undue time advantage or
disadvantage.
Additionally, individual vendors that have previously indicated an interest in providing to TCS will be
notified that the RFP is published, and advised of the GETS reference number.
4.2 Communications – General
4.2.1 Protocol
Respondents wishing to clarify the requirements of the RFP or requiring further information in order to
respond are required to observe the contact protocol set out below (Part A, Section 4.1.4):
1 TCS staff are not to be approached directly, or by phone, fax or letter.
2 Where there is a need for follow-up questions or clarification, these must be requested in writing
via e-mail to a purpose-built email address which is monitored by the Programme Manager, and
be received by TCS no later than five days before the closing date for the submission of
proposals.
3 The nature and the purpose of the request should be clearly stated by the Respondent.
4 At its discretion, TCS may schedule a meeting or provide clarification or further information by
other means.
4.2.2 Single Point of Contact
Proposals are required to include the name and full contact details of a nominated Coordinating
Officer, acting for the Respondent as a single point of contact through which further discussion or
information about its proposal can be co-ordinated (Part A, Section 4.1.6).
Procurement Plan
Page 7
Systems Replacement Project
Stage 2
4.2.3 Registration of Intent to Respond
Vendors have been advised (but are not required) to “register” their intention to respond (RFP Part A,
Section 4.1.5).
The Programme Manager will maintain the register.
All communications are via purpose-built email accounts; copies of all emails will become part of audit
log which will be included as an appendix to the Tender Evaluation Report.
The Programme Manager will monitor email accounts and coordinate responses (with appropriate
advice).
4.3 Requests for Additional Information
The following procedures will be applied when vendors request additional information:
• the RFP specifies the single point of contact at TCS for requests for additional information or for
clarification on the interpretation of the requirements;
• the mandatory recording of the questions and responses given;
• the maintenance of an Intending Respondent register to record RFP package copy holders, and
• any amendment to, or clarification of, the tender documents are passed to the RFP package
copy holders by way of a formal notification.
4.4 Receiving Responses
4.4.1 On Time
The following procedures are to be implemented for the receipt of responses to the RFP:
• the date and time of receipt of each response is to be recorded;
• responses will be securely stored until they are opened, and
• responses will not be opened until the nominated closing time.
4.4.2 Late Responses
Where a late proposal is received, the time and date of receipt shall be noted on the document and
endorsed by the recipient. Late and incomplete proposals may be admitted to evaluation at the
absolute discretion of TCS (RFP rules, Part A, Sections 4.2.2 and 4.2.29). In deciding whether to
admit a late proposal for evaluation, the TCS may take into account any factors it considers relevant,
including without limitation:
• whether the late vendor is likely to have had an opportunity to obtain some unfair advantage from
a late submission;
• the lateness of the proposal;
• the reasons given for lateness and evidence available;
• whether the proposal was mishandled by the TCS, by an official postal service or by a reputable
delivery service, and
• evidence of unfair practices.
4.4.3 Individual Vendor Extensions
TCS will not agree to a request by an individual vendor to extend the time for submitting a proposal,
unless there are exceptional circumstances.
In such a case, the extension will be advised by means of an addendum to the RFP documents,
which is to be given to al vendors‟ with sufficient notice to enable all to benefit (RFP rules, Part A,
Sections 4.2.11).
Procurement Plan
Page 8
Systems Replacement Project
Stage 2
4.5 RFP Recall
TCS has reserved the right (Part A, Section 4.2.30) in its sole discretion to withdraw, cancel or amend
this RFP at any time.
The RFP may be recalled if:
• all of the responses received are non-compliant – whether contractually or technically;
• the responses received cannot be adequately or fairly compared, in the view of the Evaluation
Teams;
• there is evidence of collusion between vendors, or
• there has been a significant change to the requirement.
All vendors will be formally advised that tenders have been recalled, and the reasons for the decision.
However, TCS will not be liable to compensate any Respondent if the RFP process is cancelled,
withdrawn or amended.
TCS has reserved the further right (Part A, Section 4.2.29) to “not accept the lowest or any proposal,
or enter into any contract”
4.6 Extending the Tendering Period
If it becomes necessary to recall the RFP and reissue, the tender period is to be extended as
appropriate.
Procurement Plan
Page 9
Systems Replacement Project
Stage 2
5 Evaluation Process
Processes must be constructed and carried out ethically and with probity, to ensure those involved in
purchasing activities act with honesty and maintain the highest ethical standards in all business
dealings.
They must ensure:
• that the tendering processes is conducted with honesty, fairness and in good faith;
• any conflict of interest or potential conflict of interest will be managed as soon as possible after it
has been declared or discovered;
• participants in the procurement and evaluation process do not engage in any practice, including
an improper inducement, which gives anyone an unfair advantage over another;
• vendors submitting responses and proposals must be prepared to attest to their probity, and not
engage in any form of collusive practice;
• each potential vendor must be subject to the same terms and conditions of tendering as every
other potential vendor;
• all requirements must be clearly specified in the tender documents and criteria for evaluation
must be clearly indicated;
• evaluation of proposals must be based on the conditions and selection criteria defined in the
tender documents and evaluation plans;
• to protect the integrity of the procurement, appropriate standards of confidentiality must be
maintained by all Evaluation Team members and key individuals, and
• all participants meet their legal obligations.
Sourced from
Procurement Statement of Good Practice, Office of the Auditor-General (OAG)
5.1 Précis
The Programme Administrator will prepare a précis of responses for evaluation teams, including
whether conforming to RFP rules, key features of response; make additional copies or excerpts as
required.
5.2 Evaluation Teams
Three Evaluation Teams will be established, each with a specialist focus: (1) functional/operational,
(2) financial, and (3) business. They will be supported, where required, by additional specialist
(e.g. legal) advice.
5.2.1 General Responsibilities
The Evaluation Teams will be responsible for:
• maintaining probity;
• validation of the evaluation criteria and weightings;
• evaluating the responses in accordance with the criteria and methodology;
• documenting the evaluation process;
• preparing an Evaluation Report;
• assisting the Programme Board, as may be requested, with final selection and reference
checking;
• debriefing the unsuccessful respondents.
Additionally, the business Evaluation Team will be charged with the further responsibility of collating
the scores and comments of all three teams, to develop an overall ranking.
Procurement Plan
Page 10
Systems Replacement Project
Stage 2
5.2.2 Composition of Teams
5.2.2.1 Business Evaluation Team
The Business Evaluation Team comprises the CEO and three DCEs, and the same team will assess
proposals for all applications: SMS, OTLE and EDRMS.
The focus of the business evaluation is two-fold:
• Suitability of the vendor as a business partner for TCS, including consideration of the vendor‟s
acceptance, or proposed changes, of the pro forma contract included in the RFP
• Risk assessment of the vendor, the product, the contract, and the implementation plan (informed
by appropriate input from Financial and Functional Teams)
5.2.2.2 Financial Evaluation Team
The Financial Evaluation Team comprises the DCE Capability Services and CFO.
The same team will assess proposals for all applications: SMS, OTLE and EDRMS.
The focus is:
• Financial security of vendor
• Assessment of cost schedule (coherent, comprehensive, total cost over lifetime)
5.2.2.3 Functional Evaluation Teams
The Functional Evaluation Teams will assess both (1) the functional and operational suitability of the
products and (2) the Respondents‟ implementation plans, against the defined business needs.
Subject to possible final adjustments, the membership of each of the teams is:
Person
SMS
OTLE
EDRMS
chair
chair
chair
Procurement Plan
Page 11
Systems Replacement Project
Stage 2
Person
SMS
OTLE
EDRMS
5.2.3 Specialist Advice and Support
Evaluation Teams may, as required, call upon specialist advice to assist in the evaluation process.
The areas of experience may include:
• subject matter knowledge, from operational staff
• probity
• legal issues
5.3 Team Conduct
Evaluation team members must perform their duties and conduct themselves in a manner which
maintains the integrity of the process and results in a fair and unbiased treatment for all vendors.
5.3.1 Communication with Vendors
It is possible that some aspects of Respondents‟ proposals may be unclear to the Evaluation Teams,
and clarification may be sought from individual Respondents.
Informal communication between the Evaluation Team and Respondents, however, could prejudice
the integrity of the procurement evaluation. Thus, all communication with external parties is to be
conducted as follows:
• The text of the communication will be reviewed and approved by the Chairperson of the
Evaluation Team.
• A copy will be provided to the Programme Manager, who will record it and file the copy in the
audit log which will be included as an appendix to the Tender Evaluation Report.
Such communications shall not be revealed to any other party, except in accordance with this
Procurement Plan.
5.3.2 No Canvassing/Undisclosed Benefits
Evaluation team members may not accept any gifts, including, without limitation, hospitality, from any
of the Respondents, for a specified period after the evaluation.
The RFP rules (RFP Part A, Section 4.2.19) forbid Respondents‟ representatives from directly or
indirectly canvassing or offering any form of inducement or reward to any TCS representative in
respect of this RFP, and advises that the likely consequence of any such behaviour is the immediate
rejection of the Respondent‟s proposal.
Any evaluation team member, believing themselves to have been improperly contacted, should
immediately inform the Programme Manager who will record the details in the audit log and
immediately escalate the matter to the Programme Board.
5.3.3 Declarations of Interest
“Impartiality and transparency in public administration are essential to maintaining the integrity of the
public sector. Where activities are paid for by public funds or are carried out in the public interest,
members of Parliament, the media, and the public will have high expectations.”
However, “[i]n a small country like ours, conflicts of interest in our working lives are natural and
unavoidable. The existence of a conflict of interest does not necessarily mean that someone has done
something wrong, and it need not cause problems. It just needs to be identified and managed
carefully” (from
Managing conflicts of interest: Guidance for public entities, Office of the Auditor-
General).
Evaluation Team members are required to disclose any actual or apparent conflict of interest and take
steps to avoid that conflict. The responsibility lies with each Evaluation Team member to promptly
Procurement Plan
Page 12
link to page 11
Systems Replacement Project
Stage 2
identify and disclose to the chairperson any actual, perceived or potential conflicts of interest involving
themselves, their immediate family or any other relevant relationship.
All disclosures of conflicts should be fully documented.
5.3.4 Confidentiality of Information
The RFP (Part A, Section 4.2.13) commits TCS to using best efforts to maintain the confidentiality of
information submitted in Respondents‟ proposals, while noting that TCS is “subject to various
disclosure obligations, such as the Official Information Act 1982.” Respondents are advised to clearly
indicate those parts of their proposals which they regard as commercially sensitive and confidential.
Maintaining the highest levels of confidentiality is essential to ensuring the probity and fair dealing
within the procurement process. Confidentiality is essential at all stages of the process and
information should only be provided to people outside the Evaluation Team only on a „need to know‟
basis. The number of persons given access or having access to the information should be kept to an
absolute minimum.
The disclosure of information contained in responses may prejudice the commercial interests of the
companies concerned and the bargaining position of the TCS during subsequent contract
negotiations.
Where consultants are engaged to provide specialist advice or undertake part of the evaluation of
tenders they will be required to sign a Confidentiality Agreement, and undertake not to disclose any
confidential information for a specified period after the evaluation.
All documents and proceedings of the procurement process are „Commercial-in-Confidence‟ and are
to be secured when not in use by members of the Tender Evaluation Team.
5.4 Briefing
All members of the Evaluation Teams are to be made aware of their responsibilities, required conduct,
and the need to demonstrate impartiality and equity to all respondents.
5.5 Methodology
5.5.1 Filtering
Non-compliant proposals may be considered at TCS‟s sole discretion (RFP rules, Part A, Sections
4.2.2 and 4.2.29).
Proposals may be initially eliminated from further consideration for such deficiencies as late
submission, poor preparation, or an evident lack of understanding TCS‟s requirements.
Proposals so eliminated will be set aside, and only re-admitted to consideration if the qualifying
responses fail to meet expectations.
5.5.2 Scoring
Each Evaluation Team will consider each of the proposals using the agreed evaluation criteria,
scoring and weightings.
Each Evaluation Team member is asked first to read and evaluate each proposal
independently: The
RFP response evaluation scoring will be completed individually by each Evaluation Team member
using an Evaluation Spreadsheet created for this purpose. All the Evaluation Team members will
participate in the evaluation of responses, and there will be no reviewer weightings applied to the
score each generates.
Questions arising during scoring may be posed to the Respondent using the protocol described in
Section
4.3.
The Evaluation Team will then meet to examine their aggregate scores, and use this and the
evaluation of proposal risk and cost/ price evaluation to determine the most suitable vendors from the
perspective of their evaluation focus.
Procurement Plan
Page 13
Systems Replacement Project
Stage 2
5.5.3 Evaluation Report
Each Evaluation Team is to complete an evaluation report at the end of the evaluation process, for
consideration by the Selection Panel. The following information is included in the evaluation report:
• background to the process;
• the evaluation process, including
o the order of preference of tenders;
o comments and scores against each criteria;
• any further recommendations, such as
o proposed methods for management of risks;
o identification of any matters which should be resolved by negotiation, and
o recommendations for vendor engagement.
5.5.4 Short Listing (Down Select)
The Business Evaluation Team will collate the scores and comments of all three teams, to develop an
overall ranking.
The exact number of short-listed vendors will depend upon the construction of the proposals (whether
individual or joint) and whether TCS needs to confirm a specific consortium.
Notwithstanding practical limitations to the number of vendors which can be investigated in detail in a
reasonable time, good proposals should not be excluded at this stage simply to “keep the numbers
down”.
Procurement Plan
Page 14
Systems Replacement Project
Stage 2
6 Selection Process
6.1 Selection Panel
Final selection will be made by a Selection Panel, comprising the Systems Replacement Project
Board members.
6.2 Revision of Business Case
Proposals are required to present high-level project plans and full financials for the supply and
implementation of the applications. Using this information, it will be possible to revise the existing
business cases and perform risk modelling for the short-listed responses.
A final revision will be prepared upon final vendor selection.
6.3 Presentations
Short listed Respondents will asked to present their proposals.
The presentations will provide them with an opportunity to highlight the key strengths of their
proposals and demonstrate the key features of their applications. A Q&A session will provide TCS
staff with the opportunity to probe key aspects of each short-listed proposal.
Minutes will be taken at each session, to record any deviations or information which is additional to
that provided in the proposals. The Programme Manager will request the vendor to confirm any such
departures in writing, as soon as practical after the presentations.
The Selection Panel may reassess proposal scores after the presentations.
6.4 Final Selection
The final step is to compile a final, overall ranking of the short-listed Proposals from consideration of:
• the Evaluation Reports from the separate teams;
• the presentations by short-listed Respondents;
• the revised business case, including the risk analysis; and
• the qualitative aspects of the vendors and proposals, which are not easily captured with scores
and weightings.
Final selection will be performed by the Selection Panel. In the event the Panel is not unanimous,
additional weight will be accorded the views of the TCS employees, whose association with the
chosen vendors and products will be longer those that of the external members.
Following final selection, a recommendation forwarded from the Systems Replacement Project Board
to the BOT.
A summary of key considerations and notification of the final selection should be provided to the
Programme Manager for inclusion in the Tender Evaluation Report.
6.5 Due Diligence
Having made a final selection, the Selection Panel will commission all necessary research of the
short-listed vendors to assure their likely performance.
The key element of the research will be careful and detailed reference checking, preferably in person.
The person performing reference checking should not be a member of the Selection Panel, but
another trusted senior TCS manager.
Accurate records of due diligence enquiries and findings will be copied to the Programme Manager for
inclusion in the revised Business Case, and the Tender Evaluation Report.
Procurement Plan
Page 15
Systems Replacement Project
Stage 2
7 Agreement and Notification
7.1 Two Step Process
Once TCS is satisfied that the provider can deliver the services, the next step is to negotiate the
contract itself. The contract sets out each party‟s undertakings to the other and is based on the criteria
defined in the RFP and the vendor‟s response. The content and wording of the expected contract is
included in the RFP document and the vendor‟s acceptance, or proposed changes, of that contractual
framework is to be considered as part of the RFP response evaluation.
As further elaborated below, the tender documents included firm and specific guidance to the form
and content of the final contract which TCS expects to execute with the successful vendors.
Completing all of the schedules to the contract will require considerable investigative work (actually,
the beginning of the implementation project) and take a few weeks. However, the principles of the
agreement can be settled relatively quickly, allowing us to notify the unsuccessful vendors, and move
forward with the implementation more confidently.
Accordingly, a two step process is planned, in which an initial heads of agreement is reached,
followed by the completion of the full contract schedules and signing of the contract itself two or three
weeks later.
7.2 Negotiation
7.2.1 Heads of Agreement
Negotiation can commence once the revised Business Case, and the Selection Panel‟s
recommendation, have been accepted.
The initial focus of negotiation with the preferred Respondent is the heads of agreement.
This step will end with the signing a heads of agreement which gives both parties sufficient
confidence to commence the initial work required to populate the schedules of a full contract.
The heads of agreement will be reviewed by legal counsel before it is signed.
7.2.2 Essential Terms and Conditions
A draft Supply and Implementation Agreement is included with the RFP documents. Subject to supply
of the necessary detailed content, TCS expects to execute this Supply and Implementation
Agreement with the successful Respondent.
All Respondents are required to acknowledge in their proposals that they have read and accept the
terms and conditions set forth in the agreement as the basis of a contractual relationship with TCS, if
selected as the supplier. The willingness of Respondents to meet TCS‟s contractual requirements is a
factor that will be taken into account in the evaluation of proposals.
Where any provision of the terms and conditions is not acceptable to a Respondent, the Respondent
must in each case:
• identify the specific provision that is not accepted;
• provide the reasons for non-acceptance;
• propose alternative wording for the clause that would reasonably protect the interests of both
parties; and
• confirm that all other clauses in the agreement are acceptable.
TCS will, at its absolute discretion, take such proposed amendments into account during the
evaluation process, but TCS is under no obligation to accept any such proposed amendments.
TCS has reserved the right to amend or replace all or any part of the terms and conditions at any time
prior to the execution of any agreement pursuant to the RFP process.
Respondents are required to agree that, if successful, their RFP response will be part of the
agreement with TCS.
Procurement Plan
Page 16
Systems Replacement Project
Stage 2
7.3 Notification
Letters advising the outcome of the process will be sent to all respondents to the RFP process. The
letters advising unsuccessful outcomes will include the following:
• a statement demonstrating the TCS‟s appreciation for the submission received;
• a statement demonstrating the TCS‟s regret that they were unsuccessful;
• encouragement to submit offers in the future; and
• advice that, should negotiations with the preferred Respondent not proceed as expected, they
may be contacted again, to discuss their earlier proposal.
The RFP documents (Part A, Section 4.1.9.3) indicates that TCS may, at its discretion, provide
debriefings for unsuccessful Respondents after the announcement of the outcome, upon request.
How TCS exercises that discretion will be decided by the Project Board, taking account of the number
of requests received and any other pertinent considerations.
7.4 Completion
Completions of the final contracts are expected prior to Christmas (late November in the best case
scenario).
Procurement Plan
Page 17
Systems Replacement Project
Stage 2
8 Stage Closure
8.1 Tender Completion Report
All activities, decisions, and findings, as outlined above, will be compiled by the Programme Manager
into a full tender Completion Report. It will include, at least:
• a summary of all proposals received;
• reasons for not admitting any tender;
• evaluation results;
• selection results and explanation; and
• the log of auditable communications and activities, as described herein.
8.2 Update Project Documentation
Systems Replacement Project documentation will be updated to reflect the new information available
from the Respondents‟ proposals and the development of the Business Case, including:
• any changes in the project governance structure to support the management of the contract;
• addressing how the performance of the contract will be measured and reported;
• defining the administrative and financial arrangements;
• updating the high level project risks and risk management strategies; and
• updating the project schedule.
Procurement Plan
Page 18
Systems Replacement Project
Stage 2
Appendix A: Abbreviations & Common Terms
This appendix contains a list of common terms and abbreviations used within this document.
Abbreviation
Description
BOT
Board of Trustees
Business Case
The fundamental document underpinning the justification for the project. It sets
out the costs and benefits expected from the new system and provide
information on the deliverables and timeframes for the investment.
EDRMS
Electronic Document and Record Management System
GETS
Government Electronic Tenders Service
heads of
A non-binding document outlining the main issues relevant to a tentative
agreement
partnership agreement. Generally, it is the agreed draft which serves as an
interim guideline for two (or more) parties who are in the process of completing
a contract.
LCMS
Learning Content Management System
LMS
Learning Management System
OAG
Office of the Controller and Auditor-General
OTLE
Online Teaching and Learning Environment, our “branding” of the LMS/LCMS
solution
RFP
Request for Proposal
SMS
Student Management System
SMT
Senior Management Team
SRP
Systems Replacement Project
Procurement Plan
Page 19
