Bayswater PT Ferry facility
Nicholas Seymour PT Improvements Project Director – February 2016
2
Introductions
Nick Seymour – Project Director AT
Marilyn Nicholls - AT Elected Member Liaison
Elaine Irvine –Panuku Development Auckland
Chris Hume – TGSRC
3
Bayswater Marina
Existing facilities and overview
Existing location of the
TGSRC Blue shed
Existing concrete Wharf
owned by AC
Proposed location for new
Existing ferry facility
ferry facility
4
Budget overview
•
Project not currently funded in the current LTP
•
AT Metro Operations have requested re-prioritisation of the Bayswater
Ferry project to commence construction late 2016 – circa $4M TBC.
•
AT Board have delegation to refine projects with LTP, subject to no
budget increase in overall LTP
•
$120K approved by AT management in Dec 2015 to progress ferry
design to completion by June 2016.
•
Budget for landside scope construction not likely before early 2018
•
Project to be staged delivery as funding becomes available.
5
Overall PT Objective at Bayswater
Deliver a new public transport interchange between ferries and buses
including
•
Upgraded concrete wharf
•
New pontoon and gangway, including associated piling, fendering
systems
•
Lighting, Power, CCTV, Signage, Passenger Information Displays,
Integrated ticketing enabled.
•
Covered waiting area for PT Users
•
Operational Staff accommodation
•
Reconfigured and formalised park n ride, drop off, Cycle facilities.
•
Reconfigured bus stops/shelters.
•
Future proofed for growth of PT Users
6
PT Facility overall Delivery Strategy
Subject to funding approval;
Stage 1 scope;
•
Design and construction of the Ferry facility and connection to landside including
concrete repairs to the existing AC owned wharf.
•
Detailed design only of the landside scope of works for Bus, Park n ride, Staff
facilities, Enhanced waiting areas, Cycle facilities.
Programme for stage 1;
•
Complete detailed design for ferry facility – July 2016
•
Complete detailed design for landside scope – Oct 2016
•
Construction of the new ferry facility by mid 2017
Stage 2 – Construction of all landside works.
Programme likely to be construct between Dec 2017 and August 2018
7
Progress to date
•
AT Metro - in progress with tendering the Ferry services contract (PTOM)
•
Confirmed option 2 for the future landside parking/bus layout.
•
Ongoing engagement with TGSRC, AC, Panuku Dev Auckland
•
Development of memorandum of understanding towards achieving
AT/PDA/TGSRC objectives.
•
Discussion around proposed Licence to Occupy (TGSRC) in progress.
•
Development of delivery programmes AT/TGSRC
•
AT Project timing vs funding for PT scope re; TGSRC future
location/tenure
•
Alternative locations considered for TGSRC Community rowing facility - 2
Sir Peter Blake Parade preferred location.
•
AT/PDA have no objection to the preferred alternative.
8
Programme overview/key dates
•
Concept design for seaward pontoon/gangway completed 2014.
•
Concept design for Landside parking layout completed 2014
•
Agreed MOU AT/PDA/TGSRC by early Feb2016
•
Licence to Occupy (TGSRC) agreed and in place – target completion
April 2016
•
Developed design Feb to July 2016
•
Detailed design July to Sep 2016
•
Stage 1 Construction commence Oct 2016 to Sep 2017
•
Consenting, land designations commence May 2016
•
resource, building, coastal marine area resources
•
Ongoing discussions with BMH Ltd re ‘spitestrip’
•
Overall project completion all stages – 2nd half of 2018
9
Proposed park and ride layout, post removal of blue sheds 2017/18
Proposed parking layout 2nd half of 2018
10

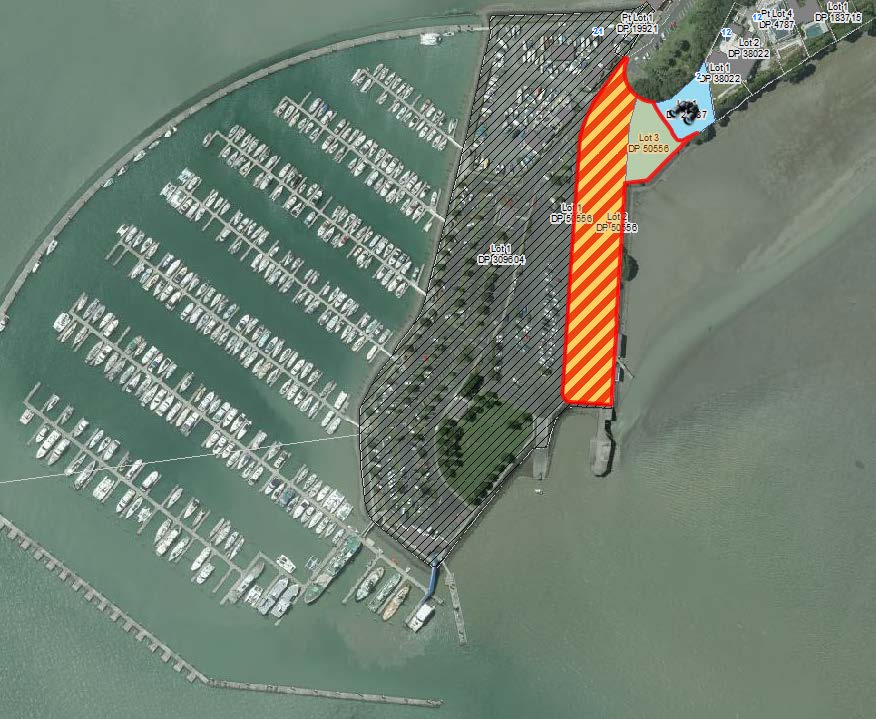

Land overview plan
Proposed location for the TGSRC Community Rowing Facility – 2 Sir PB Drive
Proposed location for the
TGSRC Community Facility
Future location for Park
and Ride and bus
accessibility/integration
11
Questions
